Start here: choose a layout, ask your building department which drawing package it accepts, then complete the dimensions and construction details for your lot. Photos and 3D designs help you choose a shape; they do not replace permit drawings.

Layout idea or permit drawings?

A layout shows the shape, size and stair position. A permit drawing set adds the structural details and site information needed to review your project.

A layout is not a drawing set. Layout idea: Shape, size and where the stairs go. Permit drawing set: Coordinated dimensions and details.
The schematic summarises the information Toronto asks for in a deck drawing set.

Check whether you need drawings

In Toronto, the short version is that an attached deck is permit work, and a detached deck more than 60 cm (24 in.) above adjacent finished grade is permit work. A detached, uncovered platform at or below that height, not part of a required exit, may not need a building permit. Our Toronto deck permit guide walks the full decision, including the enclosure rule and the applicable-law approvals that can change the path. Outside Toronto, confirm the permit requirements with your municipality.

Zoning still applies when a building permit does not. Check setbacks, lot coverage and easements before settling on a layout.

Choose a free Ontario package

OBOA Deck Guide 2022

Pick a single-beam, double-beam or house-supported end-beam layout, fill in the dimensions, then select the matching footing, beam, house, guard and stair details. PDF, hosted by Sarnia.

LimitNot accepted automatically across Ontario. Whoever signs the completed layout takes responsibility for the design.

Canadian Wood Council span guide

Look up joist, beam and column tables for four lumber groups, metric and imperial. PDF.

LimitA span reference, not a deck plan: no footings, guards, house attachment or lateral bracing, and older code references.

Compare six deck layouts

Start with the shape, connection to the house and stair position. Each illustrated example is paired with an explanatory schematic; neither is a construction drawing for your property.

Low, free-standing deck

A garden platform with a clear gap from the house and a broad, low step.

A low cedar platform separated from a brick house by gravel, with two Muskoka chairs beneath maple trees
Deck visualization · Ontario setting

How this layout works

A low, free-standing deck. Under 600 mm high: Measure from finished grade. Not attached: Separate from every structure. No roof support: The deck carries no roof. No more than 55 m²: All four conditions must apply.
Peterborough's floating-deck case works only when all four conditions are true; zoning still applies.

Layout 1 · Compact attached deck

A compact dining area and one corner stair keep the footprint simple. The schematic below explains the single-beam layout.

An attached cedar deck with black vertical guards, a corner stair and timber posts in an Ontario brick-house backyard
Deck visualization · Ontario setting

How this layout works

Attached deck: one beam. Outline: Set the overall length and width. Joists and beam: Specify sizes, spacing and each span. Footings: Size each footing from its own load. Edges and stairs: Resolve guards and the stair transition.
Layout 1 uses one beam line. Complete the spans, member sizes, spacing and footing details for your deck.

Layout 2 · More room for outdoor living

A larger footprint makes room for dining and lounging. The two-beam support arrangement is shown in the schematic below.

A spacious grey composite deck with dining and lounge areas, black guards and a side stair beside a brick house
Deck visualization · Ontario setting

How this layout works

Attached deck: two beams. Two support lines: The second beam changes the load path. Two joist spans: House to beam; beam to beam. Beam bays: State each bay’s span separately. Six footings: Each footing needs its own answer.
Layout 2 adds a second beam and support line; each span must be sized separately.

Layout 3 · House-side support

A finished deck can look similar even when its house-side support changes. Use the schematic below to understand the connection.

A cedar deck beside a brick house and exposed foundation, with black guards, a side stair and a birch garden
Deck visualization · Ontario setting

How this layout works

Joists parallel to the house. Joist direction: Changes which connection details apply. House-side support: Choose the documented connection. Outer beam: Supported by posts and footings.
Layout 3 changes the house-side support. Select the matching connection detail from the package.

Two levels · Dining above, lounging below

The stair links an upper dining deck to a separate low lounge platform; each level needs its own support and guard assessment.

Two brown deck platforms joined by a guarded staircase, with an upper dining area and lower Muskoka chairs in a wooded Ontario garden
Deck visualization · Ontario setting

How this layout works

Two levels, coordinated plans. Two framing answers: Resolve support for each level. Measure both heights: Check grade at each level. Guards at each edge: Different heights can change the rule. Shared transition: Coordinate the stair and shared edge.
Two levels mean two layouts that have to agree at their junction; each level's height and guard condition is checked separately.

Hot-tub deck · Space to unwind

Keep the tub footprint and circulation space clear in your layout. Its supporting structure requires an engineered design.

A square hot tub on a cedar deck with wide steps, a privacy screen, birch trees, pines and granite garden rocks
Deck visualization · Ontario setting

How this layout works

A hot tub changes the design. Concentrated load: Outside the prescriptive span tables. Designed support: More framing alone is not a design. Engineering package: Resolve the tub and deck together.
A hot tub creates a concentrated load outside the free package's prescriptive tables; the supporting design must be engineered.

Try a 3D design tool

Trex, TimberTech and Fiberon offer free 3D tools for trying layouts and preparing material lists:

Tool What it produces Worth knowing
Trex Deck Designer Open tool ↗ 3D design, a downloadable shopping list, and a downloadable blueprint The only one of the three offering a blueprint — Trex describes it as something you take to your local building office to check against safety codes and apply for permits
TimberTech 3D Deck Designer Open tool ↗ 3D design across decking, railing, lighting and framing, plus a downloadable take-off list Designs can be saved and compared side by side. Desktop and 8 in. or larger tablets only — it does not run on phones
Fiberon Discovery Deck Designer Open tool ↗ 3D rendering plus a Bill of Materials, shareable by email You can start from scratch or from a pre-built deck and customise it. Desktop and laptop browsers

A material list is not a permit drawing set. These tools do not supply your site plan, property lines, soil conditions or zoning information. Have the building department review any exported drawings before using them for a submission.

Each tool uses its own brand’s products. Use our decking materials guide to compare options, then check Composite Deck Shop for the current range and pricing.

What your drawings must include

Toronto asks for scaled, fully dimensioned drawings that are signed, dated and submitted as PDF. The City publishes application forms and drawing requirements, but no sample deck layout. The drawing set must show:

Footings

Size, spacing, depth, height above grade and frost-protection details.

Columns and beams

Locations, sizes and spans.

Stairs

Tread and riser dimensions and headroom, where applicable.

Guards

Construction details, opening dimensions, climbability, and guard locations at stairs, landings and platform edges.

Site plan

Referenced to a current survey: property lines, easements, structures with setbacks, the zoning summary, and the grade elevations used to confirm height.

OBOA package: sheet guide and technical limits
  • Sheet 2 carries the tables: joist spans, beam spans and footing sizing.
  • Sheets 4 and 4a give footing and pier options.
  • Sheets 5 and 5a give beam connection options.
  • Sheets 6 and 7 give ledger board and end-beam connections at the house.
  • Sheets 8 to 10 give the guardrail section plus two prescriptive guard options drawn directly from Ontario Building Code Supplementary Standard SB-7.
  • Sheet 11 gives the stair section.

The package uses the Canadian Wood Council’s Span Book 2020 for S-P-F No. 1 and 2 lumber. Its tables assume a 1.9 kPa (40 psf) live load, a 0.5 kPa (10 psf) dead load, ground snow loads up to 2.7 kPa (56.4 psf), and soil bearing capacity of 100 kPa (2,088 psf). Check that your site and design fit these limits before using the tables.

Key limits printed in the 2022 package:

Item What the sheets require
2x6 joists Only where the deck is less than 23 1/2 in. from grade and no guard is provided
Joists where a guard exists Minimum nominal 2x8 joists and rim board
Blocking A full-width row at mid span wherever the clear span exceeds 6 ft 11 in.
Beam cantilever 12 in. maximum, every size
Footing depth Minimum 4 ft, and required to be below the frost line
4x4 posts Only where the deck is less than 6 ft above finished grade and the post is not notched to carry the beam
Guard trigger and height Required over 24 in. above ground; 36 in. below 5 ft 11 in. of height, 42 in. above it
Stairs Rise 5 in. to 7 7/8 in., run 10 1/16 in. to 14 in., minimum 34 in. wide, gaps and nosing limited
Stair handrail Required at three or more risers, 34 in. to 42 in. high

Adapt the plan to your property

Cottage deck and stairs above a planted sloping garden leading to the waterfront
Start with the site: doors, slope and routes through the garden shape the layout.Photo: Delta Decks project archive.
Broad deck stairs joining two levels beside a cottage, with pale picket railings
Then resolve the levels: show stair positions and how each deck area connects.Photo: Delta Decks project archive.

Before completing a plan, gather these details:

Get your survey out

Reference the site plan to it: property lines, easements, rights-of-way, setbacks.

Measure the height

Use the greatest height above adjacent finished grade.

WhyIt decides the permit question, whether a guard is needed and how tall.

Attached or free-standing

Settle it early: it changes the ledger sheets, the connection detail and, in Toronto, whether it is permit work.

Fix the stair location

Mark it on the layout page, as the OBOA sheets ask.

WhyIt drives the framing opening, the landing and the guard transitions.

Match boards to joist spacing

Check your decking’s own published spacing; a 45-degree pattern tightens it. See the deck framing guide.

Check property restrictions

Zoning, heritage status, protected trees, ravine restrictions and easements, before fixing the location.

Confirm the accepted package

Ask your building department which package it accepts before you complete one.

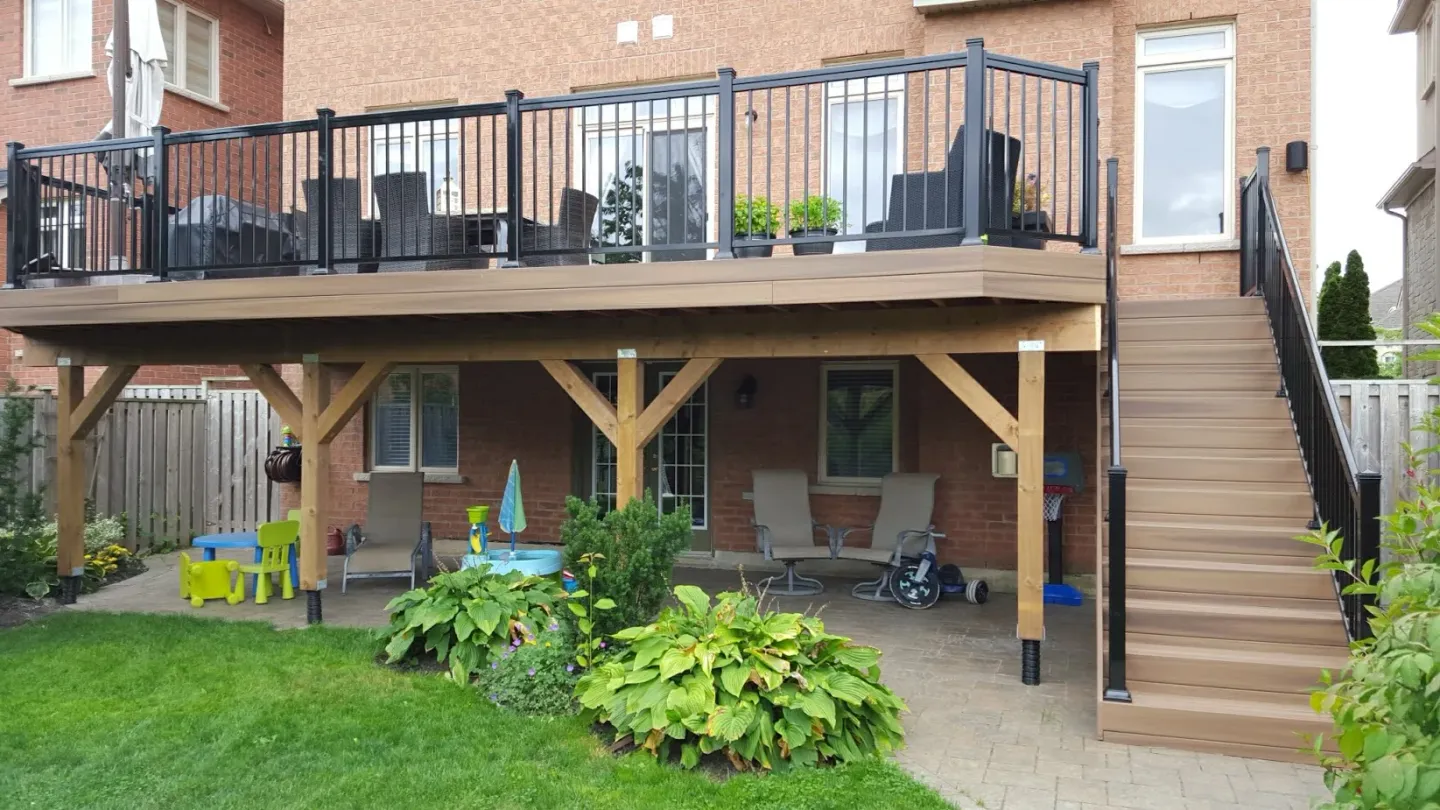

Framing of an elevated backyard deck under construction, showing joists, beams and the open ventilated space below the deck surface
Framing on a real Delta Decks project. Your drawings specify the joist spacing, beams, posts and footings before construction.

Decide who prepares the design

Peterborough allows the homeowner on title to prepare the design. If someone else prepares it, the City requires a qualified designer with at least BCIN House qualifications. Schedule 1 identifies the designer.

You, on title

Use a fill-in package for a straightforward deck inside the prescriptive tables. You sign, and you own the design.

A qualified designer

Needed the moment someone other than the owner prepares the drawings.

NoteBCIN qualification, registration and the City’s signature requirements apply.

A professional engineer

For unusual spans, a hot tub or other concentrated load, a roof over the deck, difficult soil, or a prefabricated guard system.

NoteThe OBOA sheets require the manufacturer’s engineering for a guard system and its glass.

Using a plan from the US

The American Wood Council’s DCA 6 follows the US International Residential Code. Use it for layout inspiration, but check these differences before adapting it for Ontario:

The code behind it

Check guards and stairs against the OBC and SB-7, not the US details.

DetailOntario enforces the 2024 Building Code (O. Reg. 163/24, in effect 1 January 2025), which adopts the National Building Code of Canada 2020.

The lumber

Re-check spans for S-P-F; US tables lean on Southern Pine.

DetailIncising cuts spans again — which is why the CWC publishes separate incised and non-incised tables.

Frost

Use the local frost depth; the Ontario sheets require at least 4 ft and below the frost line.

Snow

Check the plan’s snow envelope; the Ontario tables stop at 2.7 kPa (56.4 psf) ground snow load.

The signature

Identify who prepared the design; Schedule 1 or an Assumption of Responsibility for Engineering Content may apply.

Common questions

Are these deck plans free?

The OBOA, Peterborough and Canadian Wood Council resources linked here are free to access. You still need to complete the relevant dimensions and site details, and confirm which package your municipality accepts.

What does a deck permit cost in Toronto?

The City of Toronto lists $214.79 for a residential deck, porch or carport building permit, effective 1 January 2026. That is the permit fee alone — it does not include drawings, a survey, zoning relief, a tree permit or any other approval your property may need. Check the City's own page before you budget, because the fee schedule changes annually.

Useful sources

Use these sources to download the packages and confirm requirements with your building department.
